Industrial solar power plant project: what's included and which documents you need
In brief. An industrial solar plant is an engineering asset: a project built around your consumption profile, switchboard equipment, and correct connection to the electrical grid. The quality of the project determines how much the plant actually generates, how it behaves under fault conditions, and whether new technical conditions are needed at all. Below is what's included in the project, which documents are needed, and how grid connection works. One key point up front: the project scope and the list of permits depend on the plant's capacity and its connection method — what's mandatory for a multi-megawatt station may not be needed at all for a 50 kW rooftop plant under self-consumption.
Why you need a project
An industrial solar plant is designed around the site's real load profile, not on the principle of "however many panels fit." The project determines generation capacity relative to your consumption, the connection point and voltage class (0.4 / 6 / 10 / 35 kV), the single-line diagram, and the method of protection under fault conditions. Both the energy yield and safety — and whether you need to change the site's contracted capacity at all — depend on these decisions.
Two typical configurations — and why this determines everything else
Before talking about documents, it's worth being upfront about two scenarios. In most cases, it's the plant's capacity and connection method that determine how much paperwork and what equipment you'll need.
Scenario A — a solar plant for self-consumption, within already-permitted capacity. The plant (for example, a 30–150 kW rooftop system) connects to the site's internal network and works mainly to cover self-consumption. If the generation capacity doesn't take you beyond the site's already-permitted (contracted) capacity, new technical conditions for increasing connection capacity are generally not required — you aren't changing the parameters of your connection to the operator's grid, you're adding generation within your own installation. Protective functions in this scheme are handled by the grid-tie inverter (more on this below).
Scenario B — a large plant or a separate generation connection. If the solar plant's capacity exceeds the site's permitted capacity, or the generation connects separately (a primary/separate connection, roughly from a few hundred kW) — then you need technical conditions (TU) for connection, a connection project, a switchgear installation of the appropriate voltage class, a separate relay-protection complex, and a power-evacuation line. This is the "heavy" scope, and it's justified specifically for such sites — not for every solar plant.
Correctly assigning your site to one of the two scenarios is the project's first engineering decision. A mistake here costs you either unnecessary approvals that could have been avoided, or, conversely, an attempt to "squeeze through" without the technical conditions that are actually mandatory.
Solar plant project scope
The base package the customer receives:
- Technical specification (TS) — built around your site and consumption profile.
- Single-line diagram — how the plant connects to the site's internal network (and, for Scenario B, to the operator's grid as well).
- Working documentation — module layout, cable routes, support structures, grounding, lightning protection.

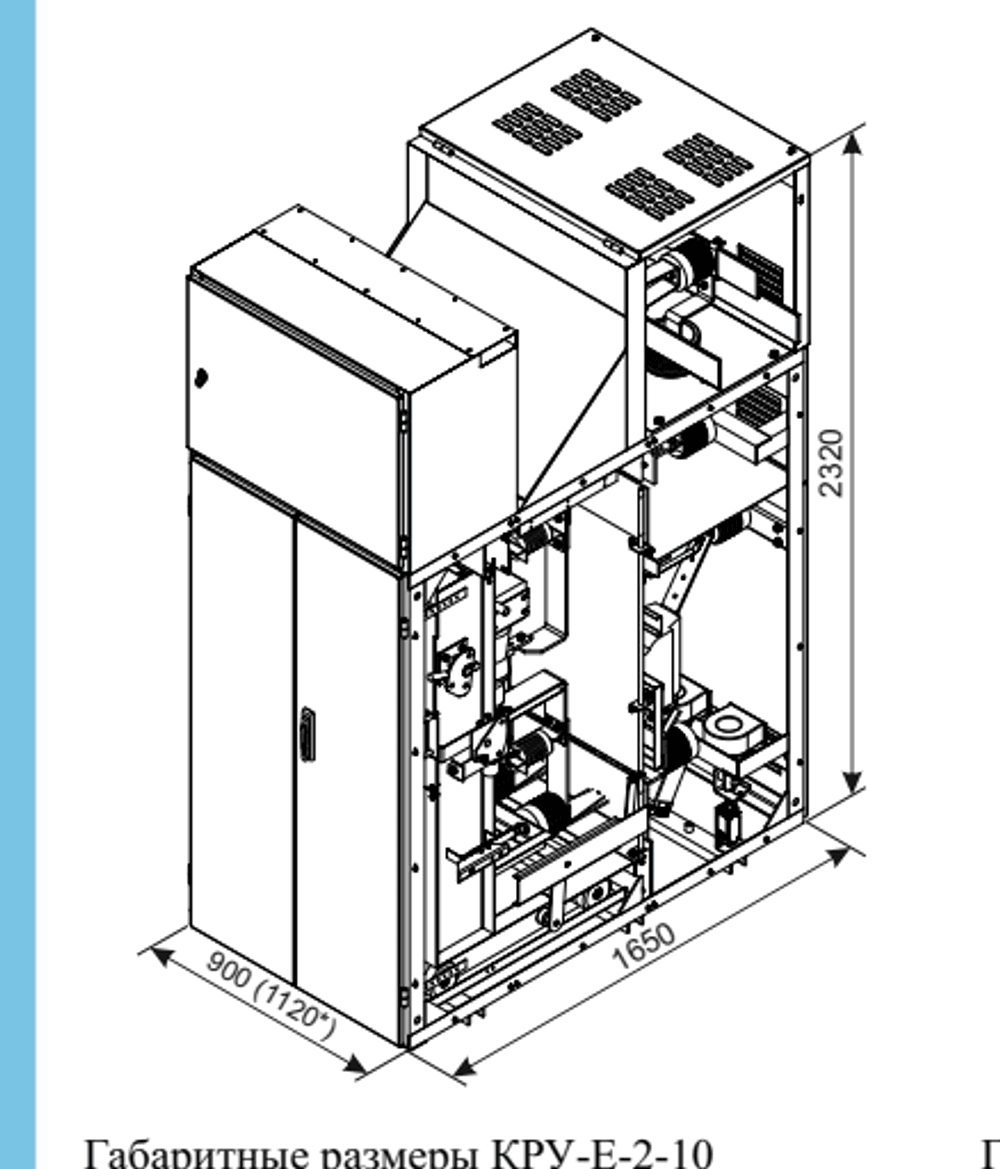

- Switchboard equipment — specification and diagrams. At LK, this is our own manufacturing: from 0.4 kV assemblies to packaged substations (КТП) and 10/35 kV switchgear.
What's added only when needed (mainly Scenario B or large sites):
- 10/35 kV switchgear installation and power-evacuation line — when there's a separate connection of generation to the operator's grid.
- Separate relay-protection complex — for plants with a power-evacuation line (roughly from a few hundred kW).
- Environmental impact assessment section — when the site's parameters fall under the relevant requirements; generally not needed for small rooftop plants.
This package is what constitutes a "solar plant project." The package scope scales with capacity: the larger the site and the closer it is to a separate grid connection, the more sections it requires.
Protection under fault conditions: inverter or separate relay protection
This is where many texts mix up small and large plants, so let's be precise.
For small solar plants under self-consumption, connected to the internal network, the key protective functions are handled by the grid-tie inverter. It implements anti-islanding protection and automatically disconnects generation when grid voltage disappears or deviates — per international requirements for grid-tie inverters (ДСТУ EN 50549-1:2022 / -2:2022). In plain terms: if voltage disappears on the operator's grid, the inverter doesn't "feed" the de-energized line — this protects both grid personnel and the equipment itself. Separate relay protection is generally not needed in this scheme.
A separate relay-protection complex (RZA) appears on larger plants — where there is a power-evacuation line into the operator's grid (roughly from a few hundred kW, or with a separate generation connection). Here, protection is built on relay devices at the switchgear installation, not on the inverter alone.
So the correct formulation is: the protection scope depends on whether the plant has a power-evacuation line into the operator's grid. Attributing full relay protection to every 50 kW rooftop solar plant is engineering-wise incorrect.
Which documents and permits are needed
The list depends on the scenario (A or B) and capacity. General guideline:
- Always: title documents for the site or roof; project documentation (scope above).
- For Scenario B (exceeding permitted capacity or a separate generation connection): technical conditions (TU) for connection from the distribution system operator (DSO), a connection project, approvals; if needed — an expert review and an environmental impact assessment section.
- For Scenario A (within permitted capacity, for self-consumption): new TU for increasing connection capacity are generally not needed; instead, if you plan to sell surpluses to the grid, active-consumer status is arranged (see the next section).
The list isn't universal, so it's always clarified at the outset for your specific site — so you don't find out during installation that something's missing (or that you ordered unnecessarily heavy procedures).
Grid connection — in brief
The connection route depends on the scenario. Scenario A: the plant sits in your own networks, within the already permitted capacity — no connection service is required: you file an application with the operator to install a generating unit, together with a single-line diagram, followed by inspection and sealing. Scenario B: increasing the permitted capacity or connecting generation separately — technical conditions (TU), a connection agreement and a connection fee are required.
If you plan to export surpluses to the grid, you obtain active-consumer status under the self-generation mechanism (net-billing): a self-generation purchase-sale contract — an addendum to your electricity supply contract — plus bidirectional commercial metering. No separate licence is needed. Net-billing compensates the value of the exported energy; it is not a guaranteed income, and for non-household consumers the permitted feed-in capacity is capped (no more than 50% of the site's permitted (contracted) capacity; household and small non-household consumers are an exception). This is why the plant is sized around self-consumption.
The decision to issue TU and the connection capacity rests with the operator — the contractor prepares the package and runs the process, but cannot guarantee the operator's decision.
→ The full walkthrough — TU issuance deadlines, the application package, statutory timelines for the connection service, fees and commissioning — is in a separate article: "Connecting a solar plant to the grid: TU, stages, documents".
Design standards
Solar plant design relies on current building codes and industry rules (electrical installations, grounding and lightning protection, fire safety), while the operation of grid-tie inverters relies on dedicated standards for connecting generation to the grid (ДСТУ EN 50549-1:2022 / -2:2022). Compliance with these standards is a condition both for passing approvals and for safe plant operation. The engineer builds the specific current editions of the standards into the project for your site.
Standard or custom project
Standard solutions (for example, packaged substations (КТП) for solar plants, standard switchboard assemblies) speed up and reduce the cost of the project. But capacity, connection method, and protection scope are always calculated for the specific site. A "ready-made project from the internet," without being tied to your site, consumption profile, and connection parameters, won't pass approvals and won't match the actual plant.
Where to start
For an assessment, we need: capacity or site area, site type (roof/ground), consumption profile, the site's permitted (contracted) capacity, and the input voltage class. Based on this data, we immediately see which scenario (A or B) applies to your site, and prepare a TS and an indicative estimate.
→ Order a project or calculation for your site. Or download the checklist "How to choose an industrial solar plant contractor."
Frequently asked questions
What is included in an industrial solar plant project? The core set: a technical brief tailored to your site and load profile, a single-line diagram, working documentation (module layout, cable routes, mounting structures, earthing, lightning protection) and switchgear — specifications and diagrams. Large plants with a separate connection also require a switchgear installation and a power-evacuation line, a dedicated relay-protection system and, where applicable, an environmental impact assessment section.
Does a solar plant need dedicated relay protection? It depends on capacity and connection method. On small self-consumption plants the protective functions (including anti-islanding) are performed by the grid-tie inverter. A dedicated relay-protection system is required on larger plants with a power-evacuation line into the operator's grid.
Are technical conditions (TU) required for a solar plant? Not always: a self-consumption plant within the already permitted (contracted) capacity operates inside your own networks, and no connection service is provided for it. TU are required when the plant's capacity exceeds the permitted capacity or the generation is connected separately. See the article "Connecting a solar plant to the grid: TU, stages, documents".
Can I use a standard project? Standard building blocks (transformer substations, switchboard assemblies) — yes; but capacity, connection method and protection scope are calculated for your specific site.
